ACCEL is a construction firm incorporated in Thailand — Korean management, a Thai working team.

Until now you had to choose between a partner you can talk to but who is weak on the ground and one that delivers but is hard to communicate with or verify. We handle both within one company.

Site selectionEstate comparison · sale terms · infrastructure review
Design · ConstructionPermits · EIA · architecture · structure · electrical · sanitary
Operations supportMaintenance · expansion · equipment rental · permit renewal

Where to build

Incentives, costs and logistics differ by region in Thailand. Tap a region to compare pros and cons.

How much does construction cost

Case · 2023–2024 · Rayong · Plastic injection factory (main process & material warehouse)

An actual project: main building (104m × 46m) plus annexes (restrooms · equipment parking · staff lounge), building + electrical · external works · cranes, about 18,000 THB/㎡ all-in.

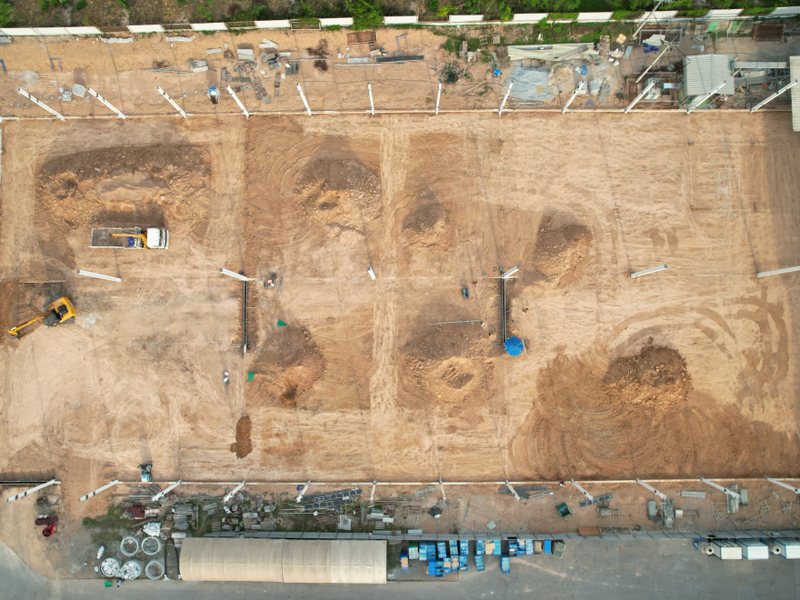

Site preparation and foundation work
1Site prep · foundation

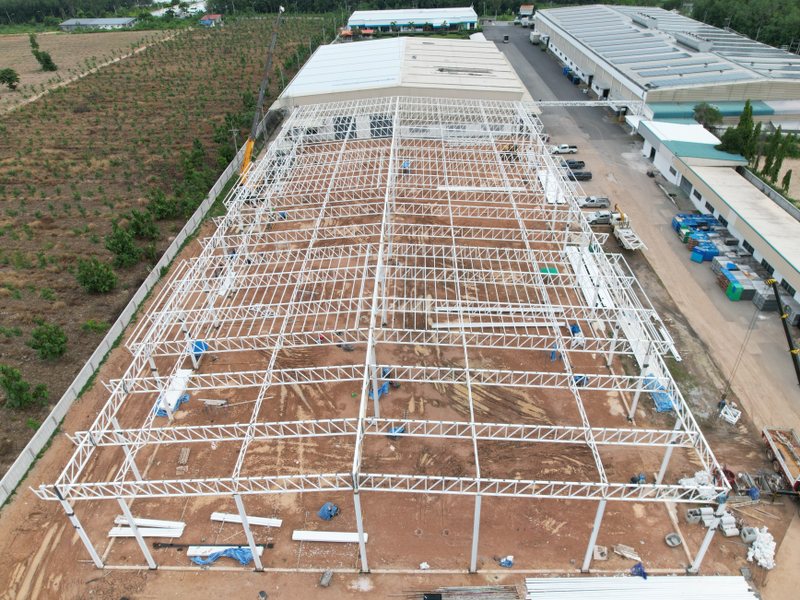

Steel structure erection
2Steel structure

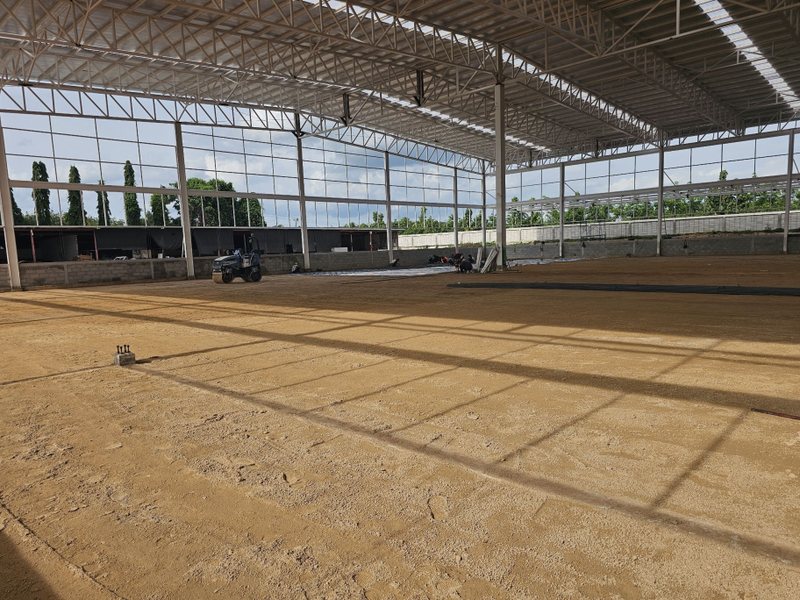

Roof and interior frame
3Roof · interior frame

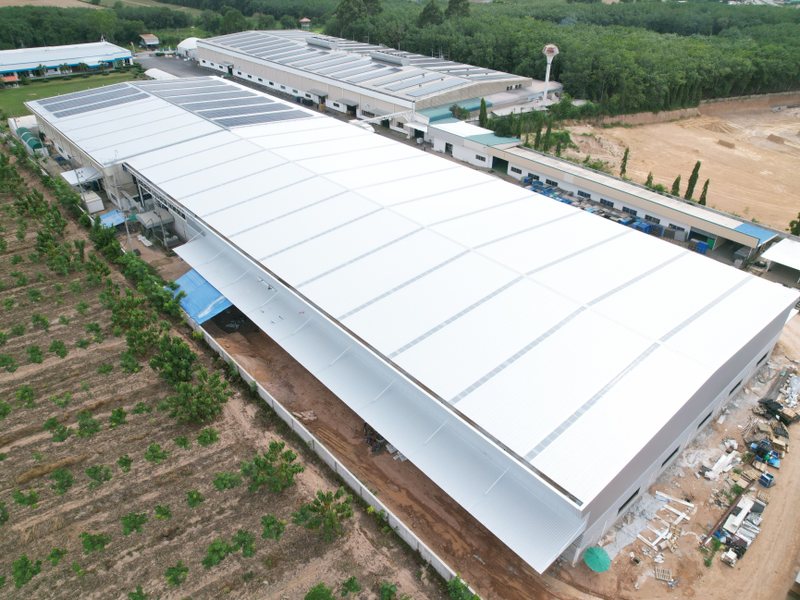

Completed exterior
4Completion

※ Actual factory construction site (managed directly by our management as site superintendent)

4,784 ㎡Main building 104×46m + annexes
≈ 18,000 THB/㎡All-in incl. electrical, external works, cranes
≈ 86 million THBTotal construction cost (excl. land)

Construction cost breakdown Total 86,112,000 THB

Work itemAmount (THB)Share
Main factory building (structure·roof·floor·walls)38,000,00044.1%
Electrical systems22,000,00025.6%
External works (paving·drainage·fencing)12,000,00013.9%
Overhead cranes 20·25 ton7,000,0008.1%
Annexes·piping·overhead etc.7,112,0008.3%

Electrical systems are a large share at about 26%. Required power capacity and equipment vary by industry, so this item moves the most.

Main building breakdown Total 38,000,000 THB

Work itemAmount (THB)Share
Steel structure14,500,00038.2%
Roof·wall cladding9,000,00023.7%
Concrete·rebar·formwork8,000,00021.1%
Flooring·earthwork·site grading3,500,0009.2%
Windows/doors·painting·ceiling3,000,0007.9%

Steel plus roof and walls are over 60% of the main building. Reducing span and height saves the most here.

· The amounts above exclude VAT (7%) and all land-acquisition costs.
· Land sale prices vary widely by region, estate and timing. Share your requirements and we will work it out for your target region.
· These figures are the actual breakdown of one specific project, to give a sense of scale. They vary with specification, ground conditions and schedule.

Tell us your requirements and we'll put it together

Just a few clicks. We won't use this for sales outreach.

Messenger IDs — whichever you use (optional)

We use what you send only to respond to this inquiry and never share it with third parties. We usually reply within 1–2 business days.
